Your area Not set — showing everywhere
Meeting report · Municipal Buildings Advisory Committee
Creating this report cost real money. Help fund coverage →

Municipal Buildings Advisory Committee — April 21, 2026

The meeting was largely informational and professional, characterized by routine progress reports and spirited discussion regarding infrastructure necessity rather than conflict.

Date Tuesday, April 21, 2026 Duration 0.2h Speakers 6 Public comments 3 Routine

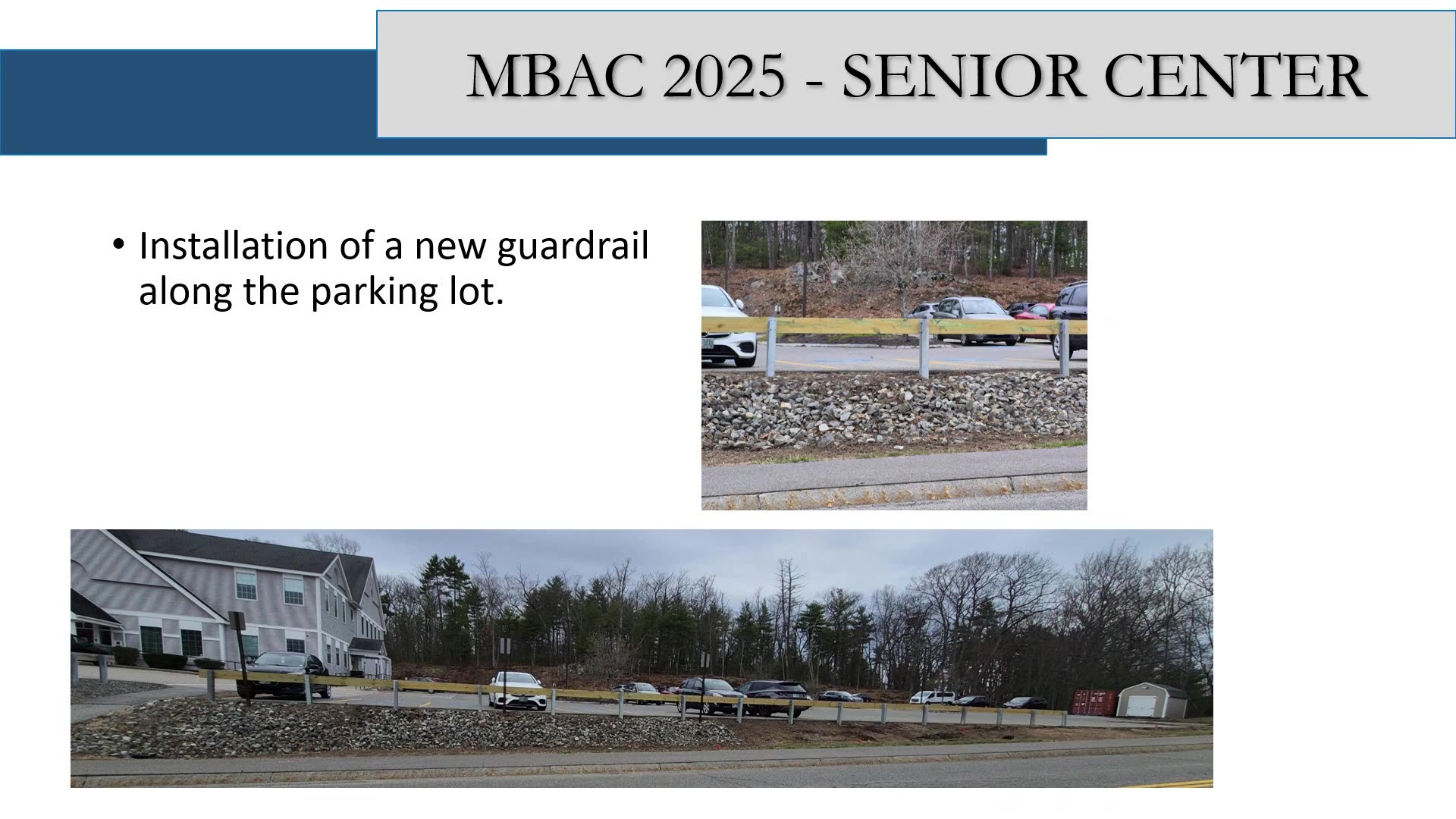

MBAC 2025 Senior Center slide: guardrail installation at parking lot Video still
MBAC 2025 Senior Center slide: guardrail installation at parking lot Frame from meeting video ▶ 04:57

Public ⁠impact

Issues from this meeting with documented community impact.
01

6-Year Capital Improvement Plan (2027–2032)

Multi-year large-scale infrastructure projects including fire stations, public works, and HVAC/roofing upgrades. Affected: All Salem taxpayers
See more
What was discussed

James Pacheco presented a long-term strategy based on Building Condition Index scores to prioritize municipal repairs. The plan includes major projects like the South Fire Station and Public Works facility, as well as long-term maintenance for water treatment and elevators.

What happened

The plan was presented as a series of estimates to guide future planning rather than fixed budget commitments.

What's next

Projects will undergo further vetting to move from estimates to 'hard numbers' for future warrant articles.

other high impact

Topics ⁠discussed

Click a topic to expand quotes and full context.
▶ 03:03 Police Station Construction Update

A progress report on the police station project indicating that construction is on schedule and within budget.

Speakers: Nicole McGee
See more
What was discussed

Nicole McGee provided visual updates showing the transformation from March 2025 to 2026. Key construction milestones include second-floor framing, sheetrocking, tactical training center epoxy painting, foyer framing, and the commencement of exterior veneer and site work.

What happened

The project was reported as being on schedule and maintaining its current budget.

▶ 03:33 South Fire Station Update

An update on the phase two design work for the South Fire Station, including discussions regarding a potential third bay.

Speakers: Nicole McGee
See more
What was discussed

The committee reviewed the proposed design schedule for phase two. There was a specific discussion regarding adding a third bay, which was noted to have minimal cost impact (extending roof/concrete/adding a door) and no apparent issues with encroaching wetlands.

What happened

The option of a third bay remains under consideration.

What's next

Tegas (Owner's Project Manager) will perform an on-site visit tomorrow, and program vetting will occur at the next meeting.

▶ 03:02 Building Condition Index (BCI) and 6-Year Capital Improvement Plan

A presentation of the BCI report and a proposed six-year capital improvement strategy (2027–2032).

Speakers: James Pacheco, Nicole McGee
See more
What was discussed

James Pacheco presented the BCI scores used to prioritize repairs, noting recent completed projects at the Senior Center and Pine Grove Cemetery. He outlined a multi-year plan including major CIP projects like the South Fire Station and Public Works facility, as well as long-term needs such as HVAC, roof replacements, water treatment renovations, and elevator updates.

What happened

The plan was presented as a series of estimates to guide future planning rather than fixed budget numbers.

What's next

Projects will undergo further vetting to move from estimates to 'hard numbers' for future warrant articles.

▶ 11:19 Courthouse-to-Town Hall Bridge

A discussion regarding the necessary repairs or replacement of the bridge connecting the courthouse and Town Hall.

Speakers: James Pacheco, Unidentified speaker
See more
What was discussed

Members debated whether to rebuild the existing bridge or remove it entirely, given that a sidewalk is located nearby. Some members argued a full reconstruction might be unnecessary if a simple repair suffices or if the bridge is removed.

What happened

The committee is considering whether to rebuild or provide an alternative pathway, noting that the Conservation Commission may have previously voted to fund repairs.

What's next

The town will look at addressing the bridge/pathway issue over the summer.

Controversy & ⁠dissent

Where the board, the community, or the agenda diverged.

Potentially controversial issues

01

Courthouse-to-Town Hall Bridge Reconstruction

There is disagreement regarding whether to spend funds to reconstruct the existing bridge or to decommission it in favor of an existing nearby sidewalk. The community is also inquiring about the source of funding, specifically whether Conservation Commission funds are being utilized.
Board position: The board is weighing the necessity of the bridge against cost-effectiveness and alternative pathways, with some members suggesting removal may be preferable.
Internal dissent
While no formal vote was taken, members expressed differing views on whether a full reconstruction is required or if a simple repair or total removal is better.
medium concern

Community vs. board tension

Action ⁠items

Who owes what, by when.
Conduct an on-site visit at the South Station
Assigned: Tegas (Owner's Project Manager) · Due: 2026-04-22

Notable ⁠statements

Nobody here believes any numbers until they actually appear on a warrant article. — Unidentified speaker · Commenting on the estimated nature of the 6-year capital improvement plan numbers. ▶ 10:12

Member ⁠positions

4 issues · 0 explicit · 0 inferred
Nicole McGee
Chair (Finance Director)
Present
Police Station Construction Update
Provided visual progress updates; reported project is on schedule and within budget.
South Fire Station Update
Presented design schedule and reviewed the option of adding a third bay.
Building Condition Index (BCI) and 6-Year Capital Improvement Plan
Presented the multi-year plan based on BCI scores for future planning.
James Pacheco
Facilities Foreman
Present
Building Condition Index (BCI) and 6-Year Capital Improvement Plan
Presented BCI scores and outlined the multi-year repair priority plan.
Courthouse-to-Town Hall Bridge Reconstruction
Participated in debate regarding rebuilding versus removing the bridge.

Positions marked ~ are inferred from context and may not reflect the member's explicitly stated position. UNCLEAR means the vote was split but the record did not name how this member voted — it is not a “yes.”

Public ⁠comment

What residents said — verbatim, with timestamps.
3
Total speakers
1
Addressed
1
Partial
1
Not addressed
Unidentified speaker
Addressed
The speaker asked for clarification regarding the timeline for repairing or replacing the bridge that connects the courthouse to Town Hall. They emphasized that the bridge is an important connection given upcoming local developments. Key concern
The schedule and necessity of the bridge repair/replacement.
Board response
James Pacheco (Facility Foreman) stated that repairs will likely be looked at this summer and noted that there are different opinions on whether to rebuild it as is or provide a different type of pathway.
The board member provided a specific timeline (this summer) and acknowledged the ongoing discussion regarding the method of repair.
Unidentified speaker
Partial
The speaker played 'devil's advocate' regarding the bridge, suggesting it may not be necessary since a sidewalk is located very close by. They argued that if reconstruction is required, it might be more cost-effective to simply use the existing sidewalk. Key concern
The necessity and cost-effectiveness of reconstructing the bridge versus using the nearby sidewalk.
Board response
The speaker's sentiment was echoed by other board members (Nicole McGee and a speaker), but there was no formal direct rebuttal or decision provided by the board during the session.
While the board members agreed with the sentiment, they did not provide a definitive answer on whether the project would be cancelled or redirected in favor of the sidewalk.
Mrs. Cromayo
Not addressed
The speaker asked if the Conservation Commission had offered to pay for the bridge repairs. They mentioned they thought a vote had already taken place regarding the use of funds for this purpose. Key concern
Whether Conservation funds are being used to pay for the bridge repair.
Board response
James Pacheco stated he had heard rumors about it but did not have specific information to confirm.
The board member admitted they did not have the specific information needed to confirm or deny the status of the Conservation funding.
