School Building Committee — June 25, 2026

Lexington SBC confirms July 6 construction start and red list material standard for school project

The meeting consisted of project updates and public questions that were addressed with explanations; no votes occurred and public participation remained constructive.

Date Thursday, June 25, 2026 Duration 1.1h Speakers 22 Public comments 6 Routine

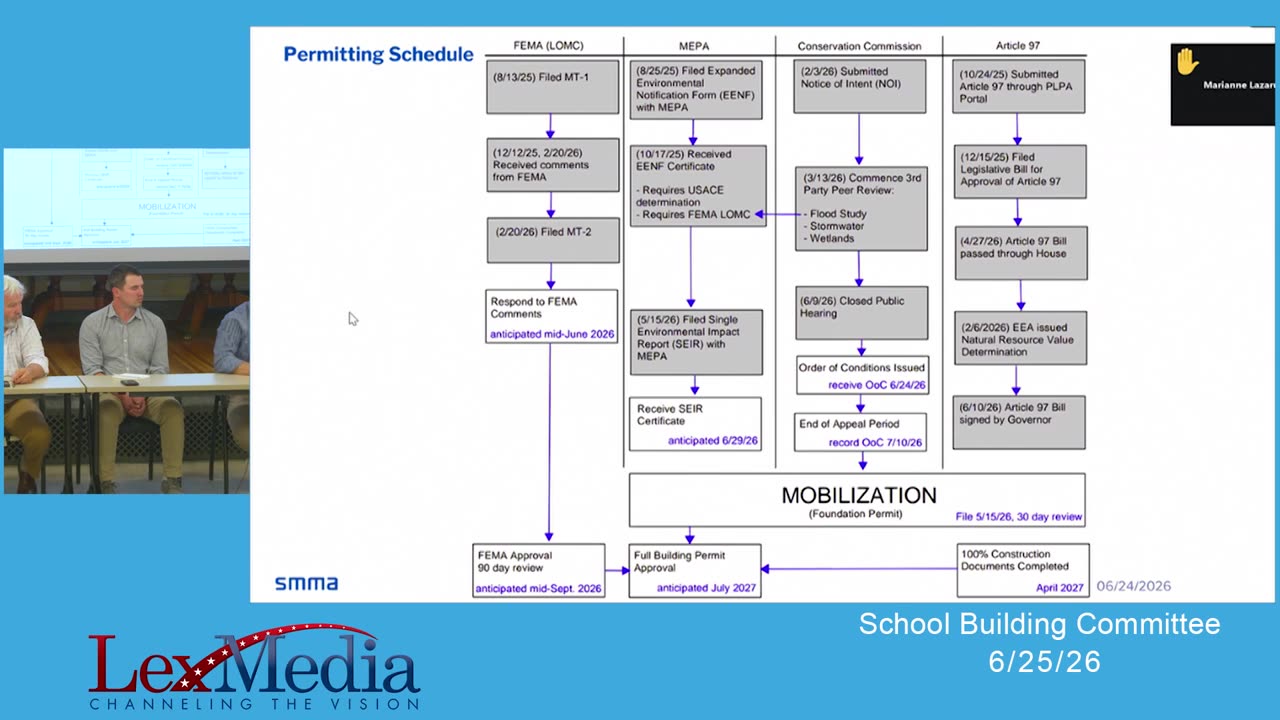

Permitting Schedule flowchart with key dates and approvals Video still
Permitting Schedule flowchart with key dates and approvals Frame from meeting video ▶ 23:58

Questions about this meeting? ⁠Just ask.

Ask MeetingWatch answers from this meeting’s report, transcript, and records — with linked sources.

Summary AI-generated to surface controversy & community impact without bias — always verify against the actual meeting before relying on it.

On June 25 the Lexington School Building Committee received updates on the new school project. Construction mobilization is set for July 6 with site fencing and two small enabling projects. The team reported that target value design has secured $2.2 million in savings without changing scope, and the DD estimate remains aligned with the prior budget. The next formal estimate is scheduled for September 21.

Design refinements presented include lighter masonry on stairwells, syncopated windows, and a specific material palette. The committee also confirmed that all components must meet the red list standard for material health hazards and that a sound consultant has been retained to manage noise from pile driving and geothermal work. Article 97 approval was secured on June 10; foundation permitting can move ahead while other reviews continue.

Jun 25, 2026 1.1h long 22 speakers 6 public comments Routine
Notable statements Drag to browse

“we are asking the construction team and the design to look at every single component to the building and make sure that it complies with the red list”

— Mike Cronin · Response to question on health hazards of materials ▶ 27:55

“we brought on a sound consultant to make sure we stay within all the time bylaws for noise”

— Dan Scholl · Addressing concerns about geothermal and pile driving noise near school ▶ 41:43
This meeting — choose a section

Topics ⁠discussed

Each topic expands to quotes and full context.
Speakers: Jacob Greco, Mike Cronin
What was discussed

Overview of design and construction timeline including early release packages, 60% CD estimate in August/September, and key milestones through 2029.

What happened

Information presented to attendees; schedule remains on track with design and early work overlapping.

Speakers: Dan Scholl, Vince Amella
What was discussed

Detailed three-year site logistics, phasing from enabling/site prep through foundations, steel, enclosure, and interiors, with emphasis on maintaining pedestrian access and school operations.

What happened

Logistics plan presented; two small summer projects (skate park relocation and throwing cage move) confirmed as enabling work.

Speakers: Brian Black, Lorraine Finnegan
What was discussed

Near-final renderings and material palette presented, highlighting Bloom scheme, simplified elevations, two-color masonry, and refinements after Monday SBC meeting.

What happened

Renderings and palette shared; design described as almost final with further review planned at SBC.

Speakers: Jacob Greco, Jamie Meiser
What was discussed

DD estimate remains on budget; target value design process has achieved $2.2M in savings while preserving scope.

What happened

Financial position reported as on budget; ongoing TVD during 60% CD phase.

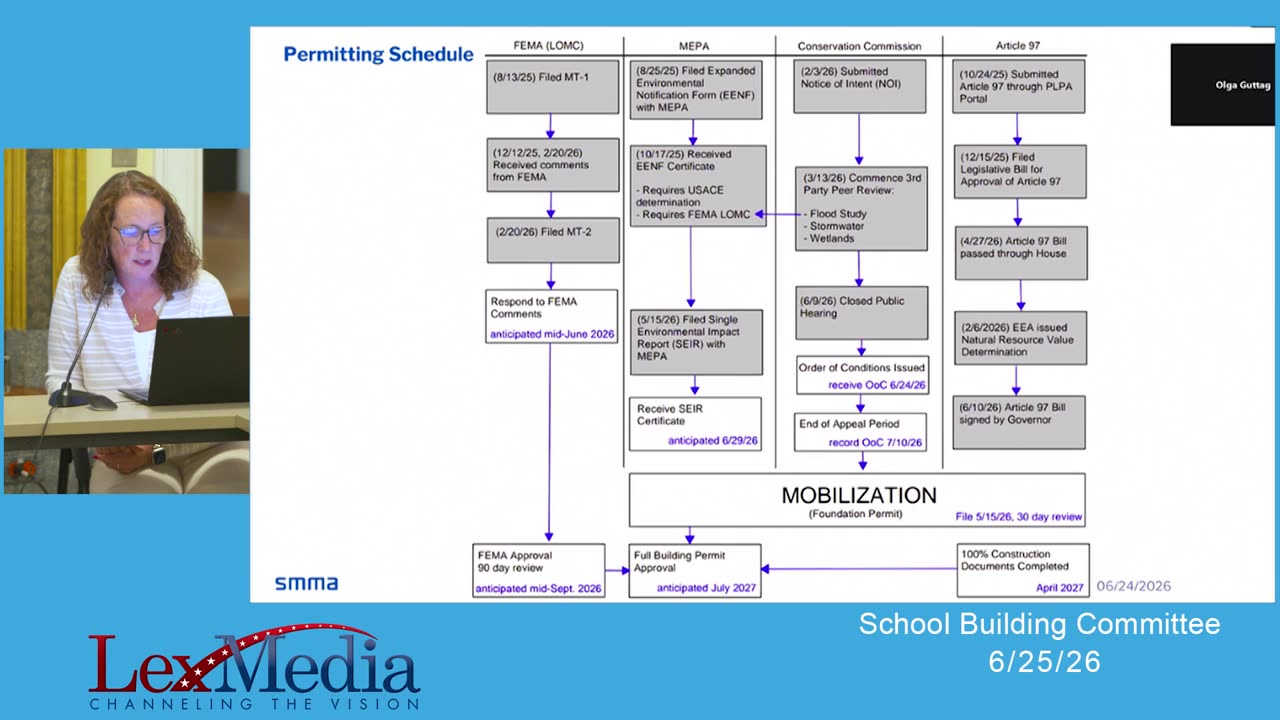

Permitting Schedule flowchart with key dates and approvals Video still
Permitting Schedule flowchart with key dates and approvals ▶ 33:49
Speakers: Lorraine Finnegan
What was discussed

Multiple permitting paths reviewed including FEMA, MEPA, Conservation Commission, and Article 97; several milestones achieved or imminent.

What happened

Status reported; Article 97 and Conservation milestones completed.

Controversy & ⁠dissent

Where the board, the community, or the agenda diverged.

Public ⁠comment

What residents said — verbatim, with timestamps.
6
Speakers
11
Comments
9
Addressed
1
Partial
1
Not addressed
Olga
Addressed
Asked about the timeline for receiving the SECIR certificate and FEMA response after the public comment period, expressing concern that federal agencies might delay or adversely respond to the submission. Key concern
Timeline and risk of delays or adverse FEMA response on flood elevation and permitting
Board response
Explained that FEMA comments would not delay construction permits, described alternate peer-reviewed flood modeling accepted by Conservation Commission, and noted FEMA approval mainly affects town insurance costs.
Board directly answered timeline, process, and contingency questions with technical details.
Maria Lazarus
Addressed
Commented on the parent pickup/drop-off area lacking weather protection and asked if any shelter would be provided. Key concern
Weather protection at parent pickup/drop-off zone
Board response
Confirmed no canopy on parent side (unlike bus side), explained design review process, student flow through commons/gym doors, and noted students currently walk between buildings in all weather.
Board explained the decision and rationale after reviewing renderings.
Olga
Addressed
Asked who is paying for skate park relocation and requested the cost estimate, expressing concern it may be underestimated given the amount of concrete involved. Key concern
Cost and funding responsibility for skate park relocation
Board response
Stated cost is borne by the project ($535k–$550k range), explained it replaces planned recreation capital work and improves track team cohesion; noted Turner has detailed cost model based on site review.
Board provided cost figure, funding source, and justification.
Olga
Addressed
Raised concerns about construction noise from geothermal drilling and foundation work near the existing high school, asking how it would affect students and whether mitigation measures (sound barriers) would be adequate given two-story buildings. Key concern
Construction noise impact on students and adequacy of mitigation
Board response
Described sound consultant, barriers, and bylaw compliance; compared to Hastings project where teachers adapted; committed to ongoing testing and additional measures if needed.
Board addressed noise controls, past experience, and monitoring plan.
Olga
Not addressed
Requested that the noise presentation given to the Select Board be posted on the project dashboard. Key concern
Public access to Select Board noise presentation
Board response
No direct response recorded in transcript to this specific request.
No acknowledgment or confirmation of posting the presentation.
Alan Levine
Addressed
Asked for location, size, and depth of the geothermal well field and for a description of field house work and schedule. Key concern
Details on geothermal well field and field house renovation timing
Board response
Provided well count (130), location under practice field/farmers market area, depth (800 ft), and explained field house work is a phase-two interior renewal plus addition with one-year schedule.
Board answered both questions with specific project details.
Olga
Addressed
Asked about final appearance of the geothermal well area and whether the underground culvert protecting the neighborhood would be impacted during construction, risking flooding. Key concern
Post-construction use of well field area and risk to neighborhood flood protection culvert
Board response
Clarified wells will be underground, area becomes bus loop/parking; stated project will not touch or relocate the culvert and all stormwater handled on-site.
Board directly confirmed no impact to culvert and explained final site configuration.
John McKenna
Addressed
Asked about plans for preserving memorabilia and memorials, especially items on the Little League field that would be disturbed by construction. Key concern
Preservation and relocation of site memorials and memorabilia
Board response
Stated all memorials have been identified with recreation input, storage/relocation plans exist, and both exterior and interior walkthroughs were conducted with stakeholder groups.
Board confirmed identification and planning process.
Olga
Partial
Expressed concern that relocating the skate park closer to the neighborhood and auditorium could create noise issues for residents and school activities; asked whether a noise study was done and what contingency mitigation exists if noise exceeds expectations. Key concern
Skate park noise impact on neighborhood and school; contingency planning
Board response
Noted sound-dampening elements in new equipment, location next to electrical yard/loading dock rather than auditorium, and committed to study and mitigation if problems arise post-construction.
Board addressed design mitigations but deferred detailed contingency planning until an actual problem occurs.
Don McKenna
Addressed
Asked about solar array coverage over parking lots and whether open, uncovered spaces would remain available; also inquired about status of Mass Ave presence/sculpture design decisions. Key concern
Solar array placement and Mass Ave visual presence design process
Board response
Confirmed mix of covered and uncovered parking with lighting; stated multiple sculpture concepts were studied and presented to the committee but no final decision made, leaving time for input.
Board clarified parking layout and confirmed ongoing public input opportunity.
Bob
Addressed
Asked for the total cost of design and construction for the Mass Ave presence/structure. Key concern
Budget for Mass Ave presence element
Board response
Stated a $100k allowance exists; design fees are already included in the architect's overall fee.
Board provided allowance amount and fee status.

Share ⁠this report

Drafts ready to post — click a block to copy, or use Share to post it.

X / Twitter — by angle

project timeline affecting school operations and residents
Lexington SBC on 6/25 reviewed school project schedule: construction mobilization starts July 6, steel erection summer 2027, full completion targeted 2029. Early packages for skate park and throwing cage relocation confirmed... https://meetingwatch.org/ma/lexington/school-building-committee/2026-06-25/ #MeetingWatch #LexingtonMA
330/280 chars
material selection standard with potential cost and scope effects
At the 6/25 meeting, SBC confirmed the design team must ensure every building component complies with the red list for material health hazards. No details given on which specific products or alternatives were under review. https://meetingwatch.org/ma/lexington/school-building-committee/2026-06-25/ #MeetingWatch #LexingtonMA
325/280 chars
construction impacts on nearby school and neighbors
SBC heard that a sound consultant was hired to keep geothermal wells and pile driving within town noise bylaws during the three-year build. Piles scheduled to begin November. https://meetingwatch.org/ma/lexington/school-building-committee/2026-06-25/ #MeetingWatch #LexingtonMA
277/280 chars

X thread

1
Lexington School Building Committee 6/25 update: DD estimate remains on budget after $2.2M in target value design savings. Next 60% CD estimate due September 21. All items presented as informational with no votes taken. #MeetingWatch #LexingtonMA
246/280
2
Design updates include Bloom scheme, two-color masonry, textured brick, and Deer Isle granite base. Renderings shown for Worthen Road, C-Wing, and Waltham Street elevations. Further material selections expected at next SBC meeting.
231/280
3
Permitting milestones noted: Article 97 signed June 10, Conservation order of conditions received. Foundation permit to proceed first while MEPA SEIR certificate and FEMA response still pending. https://meetingwatch.org/ma/lexington/school-building-committee/2026-06-25/
218/280

Facebook — long form

On June 25 the Lexington School Building Committee received updates on the new school project. Construction mobilization is set for July 6 with site fencing and two small enabling projects. The team reported that target value design has secured $2.2 million in savings without changing scope, and the DD estimate remains aligned with the prior budget. The next formal estimate is scheduled for September 21.

Design refinements presented include lighter masonry on stairwells, syncopated windows, and a specific material palette. The committee also confirmed that all components must meet the red list standard for material health hazards and that a sound consultant has been retained to manage noise from pile driving and geothermal work. Article 97 approval was secured on June 10; foundation permitting can move ahead while other reviews continue. https://meetingwatch.org/ma/lexington/school-building-committee/2026-06-25/ #MeetingWatch #LexingtonMA

Member ⁠positions

0 issues · 0 explicit · 0 inferred
Present

Positions marked ~ are inferred from context and may not reflect the member's explicitly stated position. UNCLEAR means the vote was split but the record did not name how this member voted — it is not a “yes.”

From the meeting

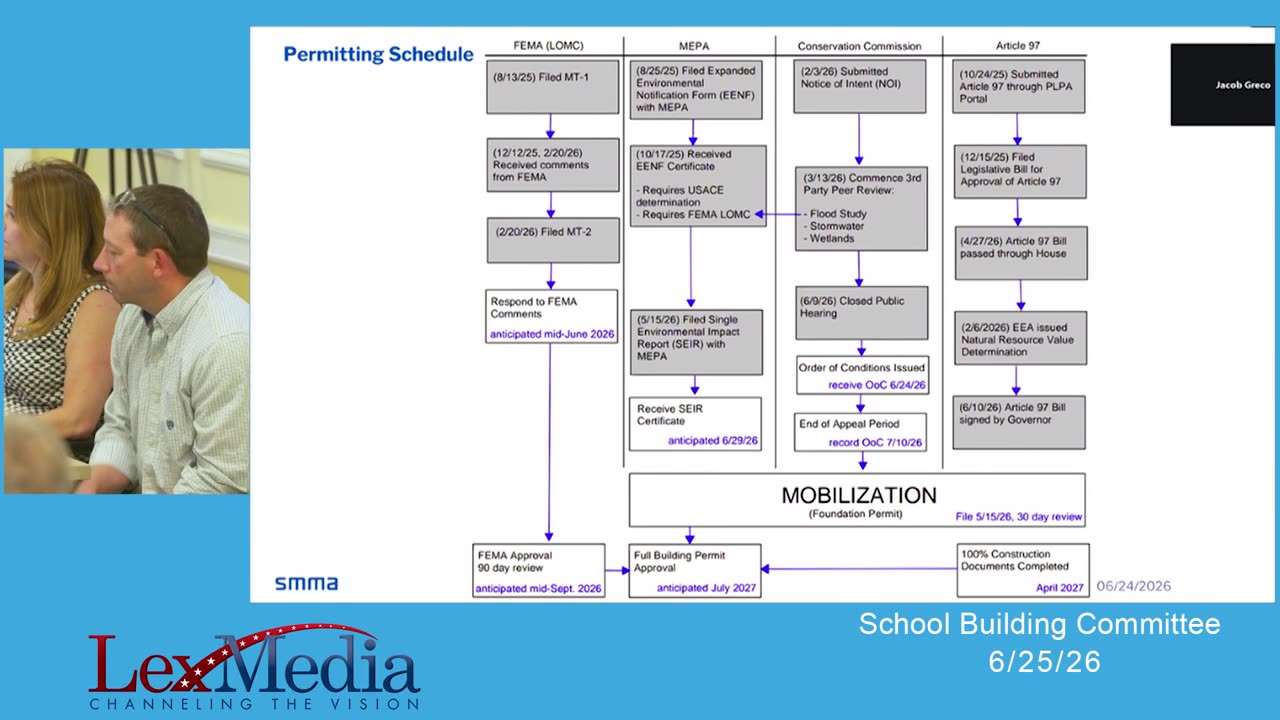

Permitting Schedule flowchart with key dates and approvals Video still
