School Building Committee — May 18, 2026

The meeting was largely professional, but tension surfaced regarding the accessibility of public engagement sessions and the financial implications of design changes.

Date Monday, May 18, 2026 Duration 1.7h Speakers 23 Decisions 3 Lively
Mechanical Room Design architectural plans and sections Video still
Mechanical Room Design architectural plans and sections Frame from meeting video ▶ 37:29

Questions about this meeting? ⁠Just ask.

Ask MeetingWatch answers from this meeting’s report, transcript, and records — with linked sources.

Summary AI-generated to surface controversy & community impact without bias — always verify against the actual meeting before relying on it.

At the May 18th School Building Committee meeting, several decisions and discussions surfaced that directly impact both the Lexington High School rebuild budget and how residents can participate in the process.

One significant item was a proposal to increase the building's height by eight inches to accommodate mechanical, electrical, and plumbing systems. This change carries a $692,000 price tag. While the committee noted this is currently covered by the design contingency, they are still investigating how these structural changes might affect the building's ability to serve the community after school hours.

There are also growing concerns regarding public accessibility. Residents challenged the district’s plan to hold 15-minute, daytime-only Zoom sessions to gather feedback on restroom design, noting that working parents are effectively excluded from these conversations. While the committee acknowledged the concern, a solution for evening or more accessible sessions has not yet been implemented.

As the project approaches major construction milestones and the budget faces ongoing pressure from 'value engineering' and design changes, residents should continue to demand transparency in how taxpayer funds are allocated and how public input is gathered.

May 18, 2026 1.7h long 23 speakers 3 decisions Lively
Notable statements Drag to browse

“We are baking into this building a pre-January philosophy [regarding building use].”

— John · Expressing concern that the current mechanical layout and access control design may not reflect updated plans for community/after-hours use of the building.

“The design contingency is more of a vehicle... it's just things that haven't been fully vetted yet.”

— Chuck · Explaining how the design contingency is used to fund the transition from design development to construction documents. ▶ 30:47

“This process is a more rigorous process involving Turner... in conjunction with what's called value engineering is an effort that's going on.”

— Unidentified speaker · Commenting on the improved scrutiny of design costs and the role of the contractor in the design phase. ▶ 1:11:42

“This is really about making sure that the whole school is branded in a way and that we are working with a subcommittee to make sure we tell the story of Lexington through the school.”

— Unidentified speaker · Explaining the purpose of Experiential Graphic Design (XGD). ▶ 1:16:15

“Listening does not equate to deciding... the SBC is not the right place to make this kind of policy decision.”

— Unidentified speaker · Clarifying the role of the School Building Committee versus the elected School Committee regarding policy matters like space usage. ▶ 1:33:14
This meeting — choose a section

Public ⁠impact

Issues from this meeting with documented community impact.
What was discussed

Management of a $534.1M project budget including $692k height adjustment and ongoing value engineering.

What happened

The board acknowledged the rigorous process currently underway to refine costs.

What was discussed

Direct impact on school facility design and community policy engagement.

What happened

The district will report the identified themes from these sessions back to the SBC.

Topics ⁠discussed

Each topic expands to quotes and full context.
Speakers: Unidentified speaker
What was discussed

The committee reviewed and voted on the minutes from the previous meeting held on April 13th.

What happened

The minutes were approved via roll call vote.

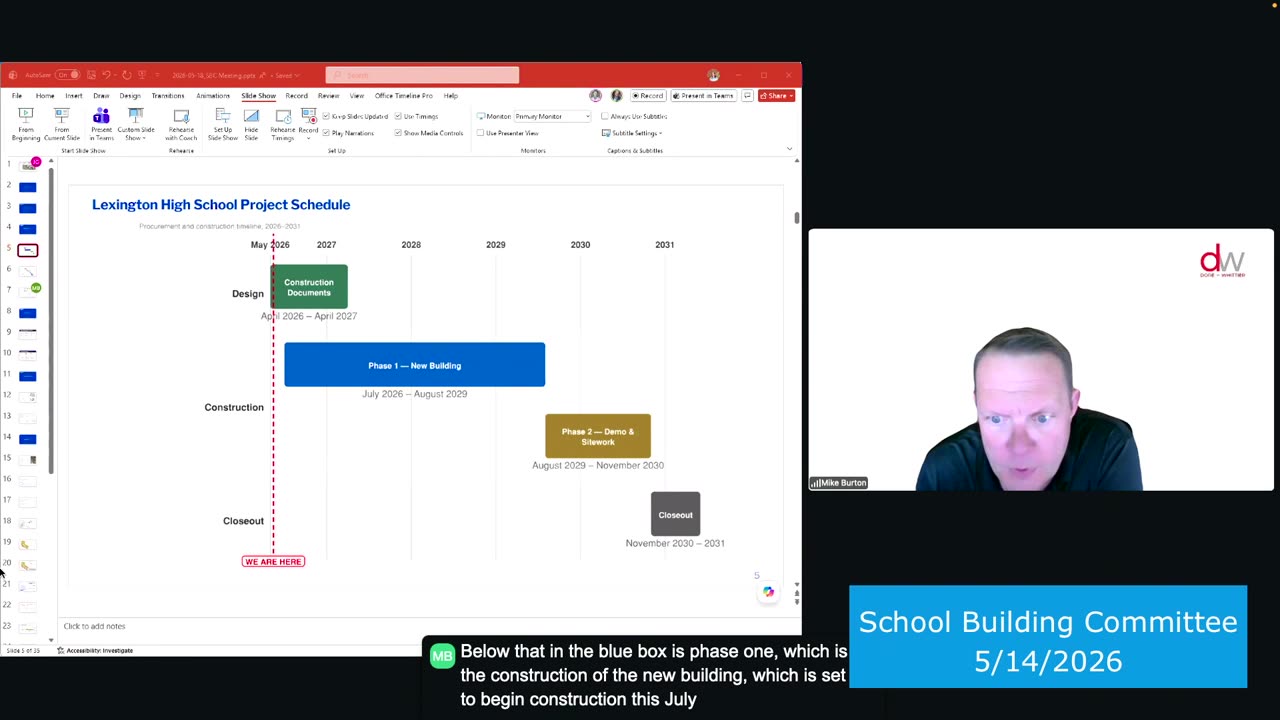

Lexington High School Project Schedule timeline 2026-2031 Video still
Lexington High School Project Schedule timeline 2026-2031 ▶ 04:41
Speakers: Unidentified speaker
What was discussed

An update on the project schedule, moving into the construction documents phase, and the introduction of a new public-facing digital dashboard.

What happened

The committee voted unanimously to move the dashboard to the project website once the design team is ready.

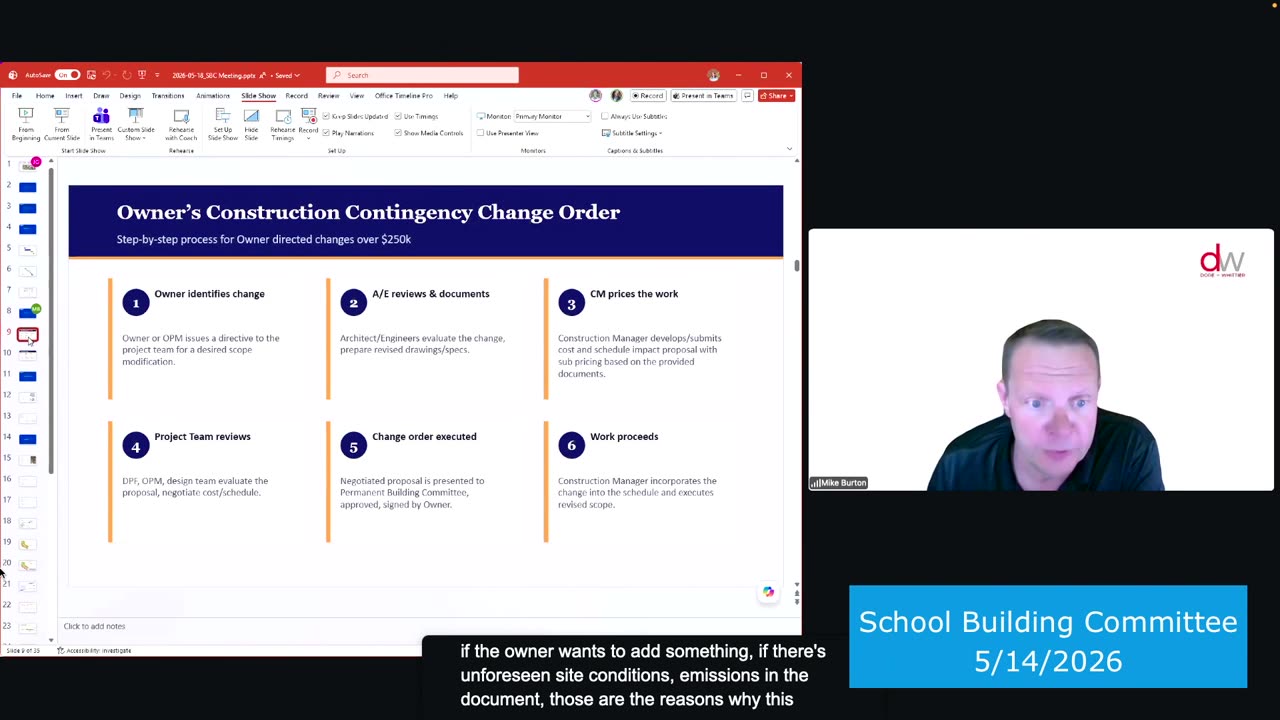

Owner’s Construction Contingency Change Order process Video still
Owner’s Construction Contingency Change Order process ▶ 25:46
Speakers: Unidentified speaker
What was discussed

Explanation of the workflows for managing Owner and Construction Manager (CM) contingencies and the thresholds for approval.

What happened

The process was clarified, and members discussed the need to elevate any changes that significantly impact the building program or aesthetics.

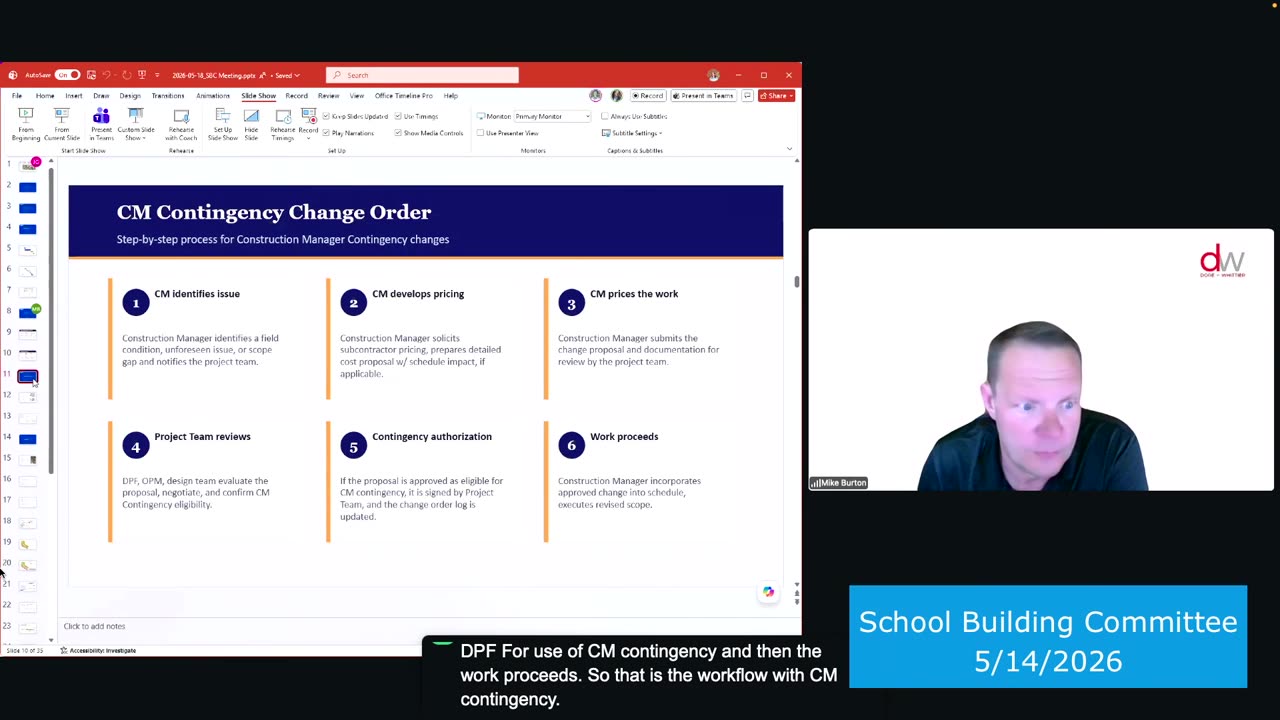

CM Contingency Change Order step-by-step process Video still
CM Contingency Change Order step-by-step process ▶ 34:47
Speakers: Unidentified speaker
What was discussed

Discussion regarding the necessity of increasing the building height to accommodate mechanical systems in the upper floor plenums.

What happened

The team recommended the 8-inch increase, noting it is funded by the design contingency and will not raise the overall project estimate. The committee expressed support for the direction but requested further discussion on community use profile.

Speakers: Unidentified speaker
What was discussed

Overview of ongoing work items being revisited to optimize design and cost.

What happened

Meetings are ongoing across various disciplines. The board acknowledged the ongoing value engineering and TBD processes aimed at managing budget increases.

Speakers: Unidentified speaker
What was discussed

An update on refinements to the exterior elevations following community engagement and architect discussions.

What happened

SMMA is working on advancing these design refinements.

Speakers: Unidentified speaker
What was discussed

An update on the process for branding the school's interior culture through visual elements like murals and artwork.

What happened

The process is underway with focus group meetings completed.

Speakers: Unidentified speaker
What was discussed

Discussion regarding the logistics of gathering community feedback on restroom design via virtual sessions.

What happened

The district will use the sessions to identify themes to report back to the SBC; they will also verify that participants are local residents.

Speakers: Unidentified speaker
What was discussed

Concerns regarding the visual impact of starting construction and the need for community communication.

What happened

The Permanent Building Committee (PBC) has requested Turner present their construction management plan at the next monthly meeting.

Controversy & ⁠dissent

Where the board, the community, or the agenda diverged.

Potentially controversial issues

01

Mechanical Room and Building Height Adjustments

Increasing the building height to accommodate MEP systems carries a significant cost implication ($692,000) and impacts the architectural profile of the building.
Board position: Supported the 8-inch increase as a compromise but requested further investigation into building use profiles.
medium concern
02

Restroom Design Feedback Logistics

The method of gathering community input is being challenged due to accessibility issues for working parents.
Board position: Acknowledged the concern and tasked the district with verifying resident status and reporting back on themes.
medium concern

Community vs. board tension

Public ⁠comment

What residents said — verbatim, with timestamps.
No public comments were identified in this meeting.

Decisions ⁠logged

Every recorded vote, with timestamps and dissents.
Approval of the April 13th meeting minutes.
The committee voted to approve the previous meeting's minutes.
Unanimous (Roll call)
Approval to post the project dashboard to the website.
The committee approved moving the draft dashboard to the website as soon as the design team is capable of posting it.
Unanimous (Roll call)
Adjournment of the meeting.
Motion to adjourn made by a speaker and seconded.
Passed unanimously (Roll call: all 'Yes')

Share ⁠this report

Drafts ready to post — click any block to copy.

X / Twitter — by angle

fiscal impact and design changes
At the 5/18 School Building Committee meeting, a proposed 8-inch increase in building height to accommodate mechanical systems came with a $692,000 price tag. The committee expressed support but is still investigating how... https://meetingwatch.org/ma/lexington/school-building-committee/2026-05-18/ #MeetingWatch #LexingtonMA
327/280 chars
community engagement accessibility
Is the Town of Lexington actually listening to working parents? At the 5/18 SBC meeting, residents pointed out that the 15-minute daytime Zoom sessions for restroom design feedback are inaccessible to those with full-time... https://meetingwatch.org/ma/lexington/school-building-committee/2026-05-18/ #MeetingWatch #LexingtonMA
327/280 chars
budget transparency and contingency use
The LHS rebuild budget is under constant pressure. During the 5/18 SBC meeting, the committee discussed using 'design contingency' to fund various changes. With a $534M project, taxpayers need to know exactly how much of that... https://meetingwatch.org/ma/lexington/school-building-committee/2026-05-18/ #MeetingWatch #LexingtonMA
331/280 chars

X thread

1
The Lexington High School rebuild is moving into a critical phase, but recent discussions at the 5/18 School Building Committee meeting reveal growing costs and accessibility hurdles for public input. 🧵 #MeetingWatch #LexingtonMA
229/280
2
First, a design change: To fit mechanical systems, the team proposed raising the 4th-floor roof by 8 inches. The cost? $692,000. While funded by design contingency, the committee is still questioning how this impacts building use and community access.
251/280
3
Second, community input concerns. The district's plan to hold 15-minute daytime Zoom sessions for restroom design feedback has been criticized by residents as inaccessible to working parents. Will the district offer evening sessions to ensure all voices are heard?
264/280
4
Finally, the budget. With a $534.1M project, the committee is heavily relying on 'value engineering' and contingencies to manage rising costs. As the project enters the construction document phase, fiscal oversight is more important than ever. https://meetingwatch.org/ma/lexington/school-building-committee/2026-05-18/
267/280

Facebook — long form

At the May 18th School Building Committee meeting, several decisions and discussions surfaced that directly impact both the Lexington High School rebuild budget and how residents can participate in the process.

One significant item was a proposal to increase the building's height by eight inches to accommodate mechanical, electrical, and plumbing systems. This change carries a $692,000 price tag. While the committee noted this is currently covered by the design contingency, they are still investigating how these structural changes might affect the building's ability to serve the community after school hours.

There are also growing concerns regarding public accessibility. Residents challenged the district’s plan to hold 15-minute, daytime-only Zoom sessions to gather feedback on restroom design, noting that working parents are effectively excluded from these conversations. While the committee acknowledged the concern, a solution for evening or more accessible sessions has not yet been implemented.

As the project approaches major construction milestones and the budget faces ongoing pressure from 'value engineering' and design changes, residents should continue to demand transparency in how taxpayer funds are allocated and how public input is gathered. https://meetingwatch.org/ma/lexington/school-building-committee/2026-05-18/ #MeetingWatch #LexingtonMA

Action ⁠items

Who owes what, by when.
Follow up with Mike Cronin regarding the 'float' on the schedule through structural steel.
Assigned: Turner (Daniela Ojeda)
Complete modeling of the first floor to determine if building height adjustments are required.
Assigned: Design Team / SMMA
Prepare a report/discussion for the next meeting regarding building use profiles (community/after-hours access) and the innovation labs.
Assigned: Staff / Design Team · Due: Next meeting
Add geotechnical structural discussion (three piles vs. two) to future agendas.
Assigned: a speaker · Due: Next meeting
Send FAQ documents regarding restroom design to the SBC via email.
Assigned: a speaker · Due: Immediate
Verify that participants in the restroom design listening sessions are Lexington residents.
Assigned: a speaker/Kathleen · Due: Before May 27th
Develop and present a space use plan for after-hours use.
Assigned: Project Team/SBC · Due: Not specified
Incorporate a standing agenda item for a report from the Financial Oversight Subcommittee (SBCFO).
Assigned: SBC Chair · Due: Ongoing

Member ⁠positions

4 issues · 3 explicit · 18 inferred
Present
Approval of April 13th Minutes YES ~
Schedule Update Dashboard YES ~
Adjournment of the meeting YES ~
Present
Approval of April 13th Minutes YES ~
Schedule Update Dashboard YES ~
Adjournment of the meeting YES ~
Present
Approval of April 13th Minutes YES ~
Schedule Update Dashboard YES ~
Adjournment of the meeting YES ~
Present
Approval of April 13th Minutes YES ~
Schedule Update Dashboard YES ~
TBD (To Be Determined) Items and Design Refinements
Noted that the rigorous process with Turner is part of robust value engineering.
Adjournment of the meeting YES ~
Present
Approval of April 13th Minutes YES ~
Schedule Update Dashboard YES ~
Adjournment of the meeting YES ~
Present
Approval of April 13th Minutes YES ~
Schedule Update Dashboard YES ~
Adjournment of the meeting YES ~

Positions marked ~ are inferred from context and may not reflect the member's explicitly stated position. UNCLEAR means the vote was split but the record did not name how this member voted — it is not a “yes.”

From the meeting

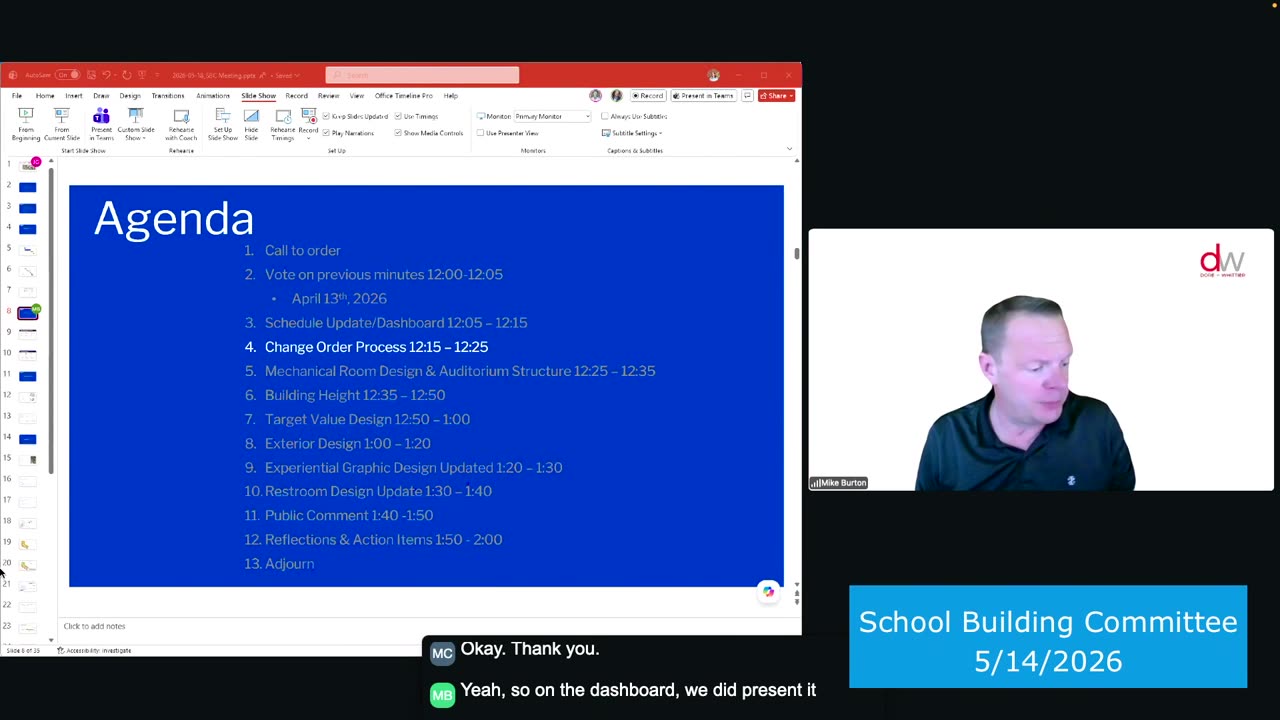

Meeting agenda slide Video still
Meeting agenda slide ▶ 13:54

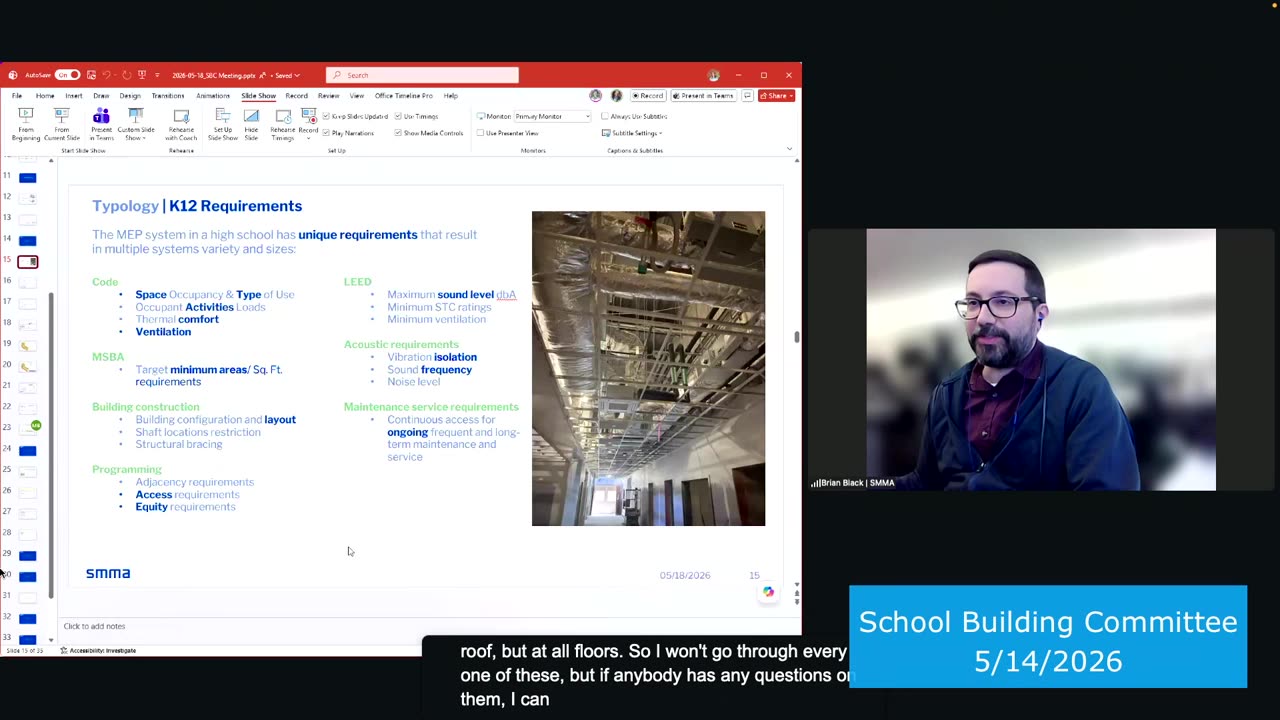

K12 Requirements typology slide with ceiling photo Video still
K12 Requirements typology slide with ceiling photo ▶ 39:44

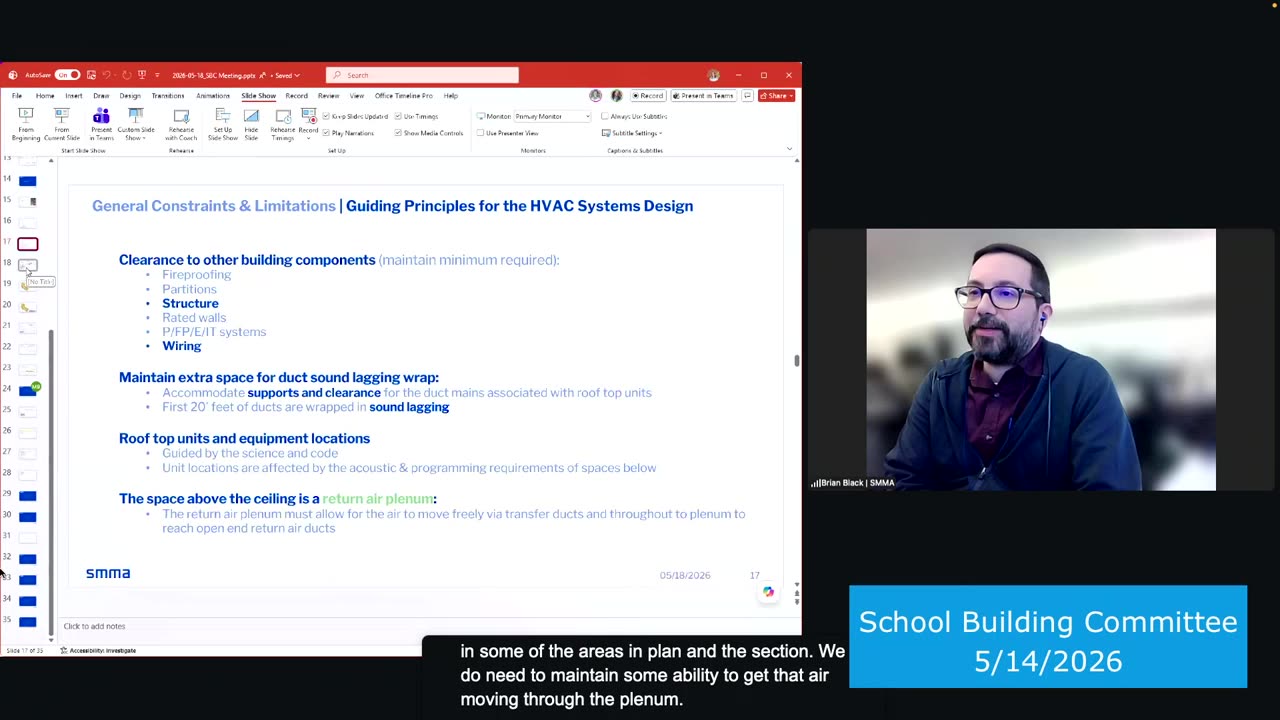

HVAC Systems Design guiding principles and constraints Video still
HVAC Systems Design guiding principles and constraints ▶ 42:38
Support coverage

Creating this report cost ⁠real money.

MeetingWatch attended, transcribed, and analyzed this meeting on its own dime. If this work is valuable to you, chip in to keep covering Lexington.

Report composed by grok-4.3, gemma-4-26b, grok-4.20-0309-reasoning · analyzed 2026-06-07.
